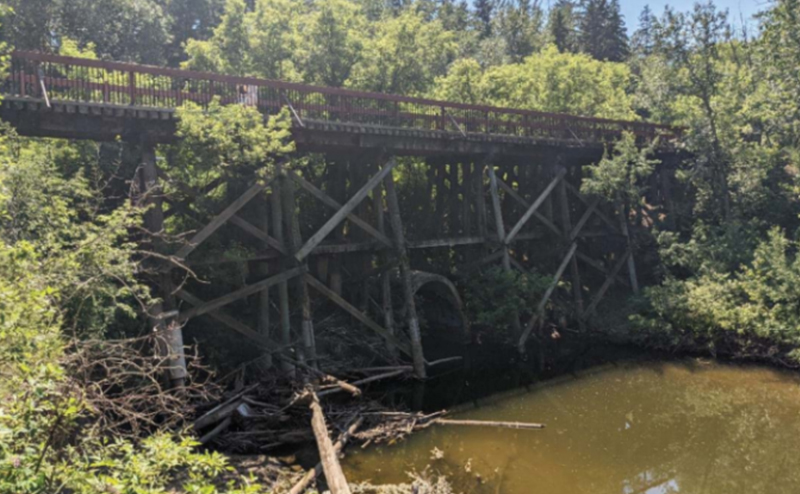

Mill Creek Ravine Trestle Bridge

Construction for the replacement of the historic trestle bridge located within Mill Creek Ravine along 76 Avenue is underway.

Project Update - March 2026

Construction on the bridge is underway and is anticipated to be completed by fall 2026. Replacement of the trestle bridge will ensure a safe crossing for those who walk, cycle and roll.

As part of this project, the culvert that carries Mill Creek under 76 Avenue will be replaced with a roadway bridge to increase ravine flow capacity and address soil erosion issues.

A temporary full closure of the pedestrian bridge and 76 Avenue is expected until project completion. Construction is anticipated to be completed in fall 2026.

Read our project newsletter sheet

Bridge Design

The replacement trestle bridge will include features similar to those of the current structure.

After further review, considering factors such as erosion and flooding risks, optimizing renewal requirements and timelines, and environmental benefits, the City has decided to replace the existing culvert under 76 Avenue with a new single-span bridge. Alongside this work, Mill Creek will be re-aligned and restored.

The new 76 Avenue bridge will maintain existing vehicle capacity through two travel lanes (one eastbound and one westbound travel lane), as well as a new shared pathway on the north side of the bridge.

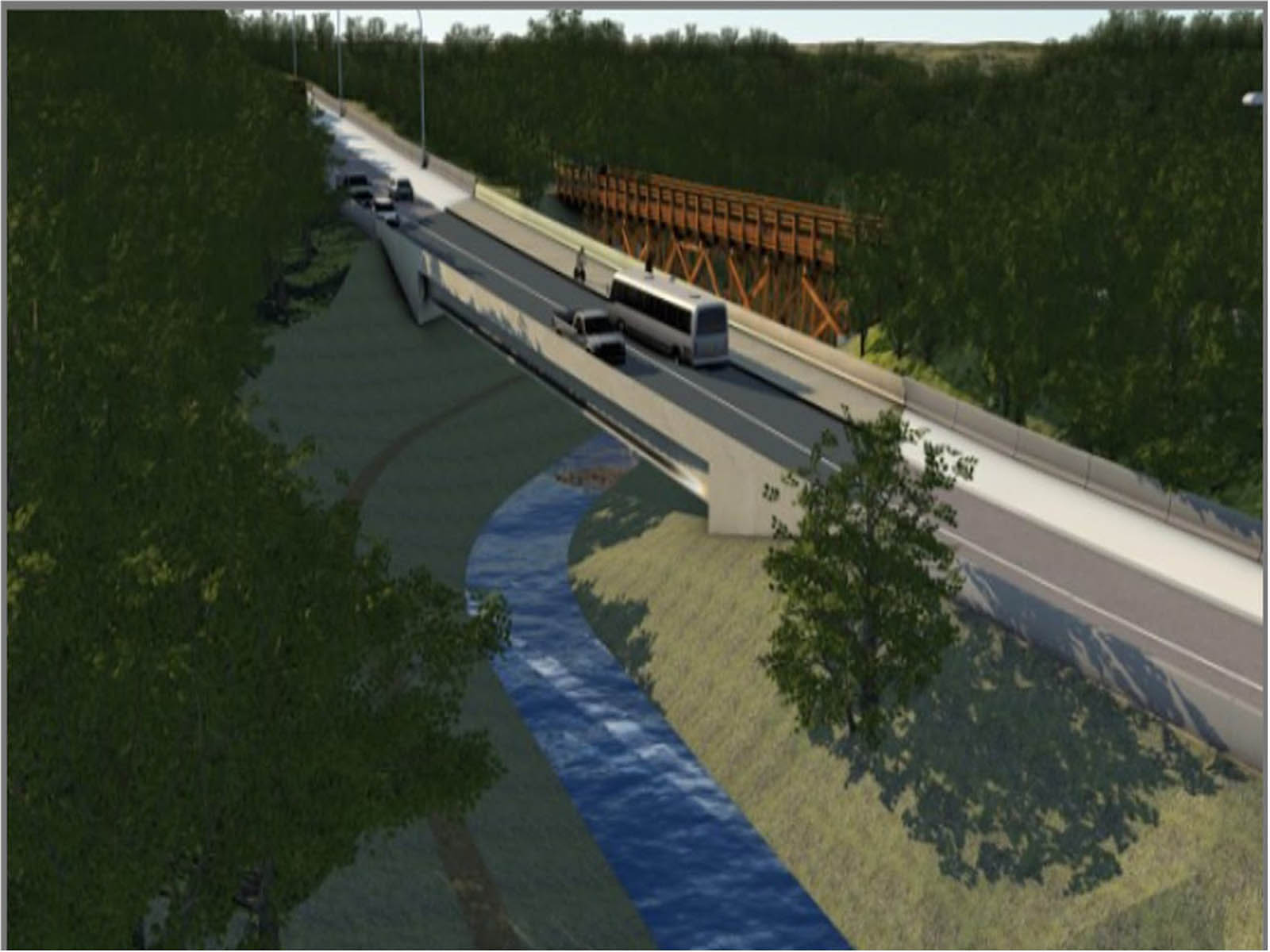

Proposed design of Mill Creek Trestle Bridge

Project Overview

The trestle was originally constructed in 1902 as part of an early rail connection between the towns of Strathcona and Edmonton. It remains a valuable part of the Edmonton River Valley trail system.

The existing trestle has reached the end of its service life, and replacement is being planned.

In addition to the trestle replacement, the project will replace the culvert (the structure that holds and directs the water) under 76 Avenue. The current culvert is aging, requiring work to address the condition as well as soil erosion and slope stability issues near the existing bridge.

Frequently Asked Questions

Mill Creek Trestle Bridge and Culvert Replacement FAQ
